KASHI TAXI 20X GROWTH OKR FRAMEWORK

12-Month Strategic Plan for Asset-Light, Tech-Enabled Scaling

Business: kashitaxi.in
Current State: 10 vehicles (3 Tempo Travellers, Sedans/SUVs) | Net Loss | Asset-Heavy Model
Target: 20X Revenue in 12 Months | Asset-Light | Commission-Based
Planning Period: Q1 2026 - Q4 2026

EXECUTIVE SUMMARY

Kashi Taxi is transitioning from an asset-heavy, unprofitable taxi service to an asset-light, commission-based platform business. This OKR framework guides a 20X revenue growth over 12 months by:

Visual Overview

Kashi Taxi Q1-Q4 2026 Metrics Figure 1: Key performance metrics showing GMV, Commission, Bookings, and Customer growth trajectory across Q1-Q4 2026

Asset-Light Transition Strategy Figure 2: Revenue transition from owned vehicles (red) to partner-operated model (blue), achieving 92% partner revenue by Q4

  1. Building a digital platform that enables partner vehicles to operate under the Kashi Taxi brand
  2. Transitioning 70% of owned fleet to partner-based commission model
  3. Diversifying revenue streams beyond point-to-point rides (tours, corporate, B2B)
  4. Expanding to 4-5 cities while maintaining profitability and unit economics
  5. Maximizing digital operations to reduce manual overhead and scale efficiently

Key Numbers at Glance:

  • Current Revenue: ~₹0 (net loss)
  • Target Annual Revenue: ₹2.25-3.6 Crore (20X from breakeven baseline)
  • Target Platform GMV: ₹15-20 Crore
  • Target Partner Network: 75-100+ vehicles by year-end
  • Target User Base: 15,000+ registered customers
  • Owned Vehicles by Year-End: 2-3 (from 10)

Quarterly Targets Summary

Metric Q1 Q2 Q3 Q4
Platform GMV (₹ Crore) 1.0 2.5 6.0 18-22
Monthly Bookings (avg) 600 1,800 4,500 7,500
Commission Revenue (₹ Lakh) 15 40 110 300
Active Customers 2,000 5,000 10,000 15,000
Partner Vehicles 18 30 50 85
CAC (₹) 200 170 160 180
LTV (₹) 300 450 600 750
App Rating 4.3 4.4 4.6 4.7
Cities Operational 1 1.5 3 4-5

Unit Economics Model

Metric Q1 Target Q4 Target
Platform GMV (Monthly) ₹33 Lakh ₹2.5 Crore
Commission Rate (%) 15% 18%
Gross Commission Revenue ₹5 Lakh ₹45 Lakh
Operating Costs ₹3 Lakh ₹12 Lakh
Operating Margin (%) 40% 73%
Net Monthly Revenue ₹2 Lakh ₹33 Lakh
Monthly Bookings 600 7,500
Revenue per Booking ₹550 ₹3,333
Cost per Booking ₹50 ₹160
Partner Vehicles Required 18 85
Revenue per Partner/Month ₹11K ₹39K

ANNUAL OKRs (REVISED - VERSION 1.0)

High-Level OKR Structure

Level Objective # Objective Rationale # of KRs
Annual 1 Build an Asset-Light Platform that Scales Shift from asset-heavy ownership to commission-based partner network 3
Annual 2 Achieve 20X Revenue Growth through Diversified Revenue Streams Commission-based model + tour packages + service diversification 3
Annual 3 Build Maximum Digital Presence & Tech-Driven Operations Extensive online presence to maximize reach with minimal manual overhead 3
Annual 4 Establish Market Leadership in Kashi with Aggressive User Acquisition Dominant local presence before expansion to adjacent markets 3

OBJECTIVE 1: Build an Asset-Light Platform that Scales

Strategic Rationale:
The core issue with the current model is the capital intensity and operational burden of owning 10 vehicles. The shift to an asset-light model requires building technology infrastructure that allows partner vehicle owners to operate on the platform while Kashi Taxi captures commission. This is the foundation for sustainable, scalable growth.

Key Result 1.1: Transition 70% of Fleet from Owned to Partner-Operated

  • Target: Retain 2-3 owned vehicles for strategic/key routes; transition remaining 7+ vehicles through sales/lease transfer
  • Success Metric: 70%+ of platform bookings fulfilled by partner vehicles by Q4
  • Why It Matters: Reduces fixed asset burden, frees up ₹40-50 Lakh capital, reduces maintenance/insurance costs
  • Quarterly Milestones:
    • Q1: Identify 10-15 potential partner vehicle owners; finalize 5-8 agreements
    • Q2: 40% partner fulfillment on bookings
    • Q3: 60% partner fulfillment
    • Q4: 70%+ partner fulfillment

Key Result 1.2: Launch Fully Functional Digital Platform (Web + Mobile + Partner Dashboard)

  • Target: MVP launch by end Q1 with core features; full suite by end Q2
  • Core Features:
    • Customer Booking App (iOS/Android): Real-time booking, GPS tracking, in-app payments
    • Driver App: Earnings dashboard, trip acceptance, customer ratings
    • Admin Dashboard: Fleet management, analytics, commission tracking, support tools
    • Partner Portal: Vehicle registration, documents, commission tracking, performance metrics
  • Success Metric: 99.5% uptime, <500ms response time, 4.5+ app rating by Q3
  • Tech Stack Recommendation (cost: ₹15-25 Lakh for MVP):
    • Frontend: React Native (cross-platform mobile), React (web)
    • Backend: Node.js + PostgreSQL + Redis
    • Payment Gateway: Razorpay/Stripe
    • Analytics: Mixpanel or custom dashboards
    • Infrastructure: AWS or Google Cloud
  • Quarterly Milestones:
    • Q1: Platform MVP live with basic booking, payment, tracking
    • Q2: Partner dashboard, advanced analytics, dynamic pricing
    • Q3: API marketplace for integrations
    • Q4: AI-driven demand forecasting, personalization

Key Result 1.3: Onboard and Activate 50+ Vehicle Partners by Q4

  • Target: Cumulative 50+ partners across all cities with sustainable activation
  • Partner Mix:
    • Individual operators (50%): 1-3 vehicles each
    • Small fleet owners (50%): 5-15 vehicles each
  • Success Metric: 50+ active partners with minimum 2 bookings/week each; 90%+ monthly retention
  • Partner Economics (to ensure viability):
    • Kashi Taxi commission: 15-20% of ride value
    • Driver earns: 80-85% of ride value
    • Partner/Vehicle owner earns: 5-10% if they retain vehicle
    • OR: Fixed daily revenue guarantee + commission if partner prefers capital-light model
  • Onboarding Process:
    • Week 1: Document verification, background check, vehicle inspection
    • Week 2: App training, payment setup, SLA agreement
    • Week 3: Live on platform with incentive (₹500-1000 bonus for first 5 trips)
  • Quarterly Milestones:
    • Q1: 15-20 partners onboarded
    • Q2: 25-35 partners
    • Q3: 40-50 partners
    • Q4: 50+ partners, <10% monthly churn

Key Result 1.4: Establish Partner Network Infrastructure & Support System

  • Target: Professional partner management team, dedicated support, performance incentives
  • Components:
    • Dedicated Partner Manager: Recruitment, onboarding, retention
    • 24/7 Partner Support: WhatsApp, phone, email for issues/questions
    • Performance Incentives: Monthly bonuses for >4.6 rating, high acceptance rate
    • Community Building: Monthly partner meetups, forums, training sessions
  • Success Metric: Net Promoter Score (NPS) from partners: 50+; partner satisfaction: 85%+
  • Investment: ₹2-3 Lakh/month for partner management team

OBJECTIVE 2: Achieve 20X Revenue Growth through Diversified Revenue Streams

Strategic Rationale:
A 20X growth target cannot be achieved through a single revenue stream (point-to-point rides). The strategy involves:

  1. Scaling core ride-hailing GMV (5-7X growth through volume)
  2. Improving margins through operational efficiency (2-3X improvement)
  3. Capturing adjacent verticals: Tours, Corporate Travel, B2B Bulk Booking (3-5X contribution)

Key Result 2.1: Grow Platform GMV (Gross Merchandise Value) from ₹0 (loss state) to ₹15-20 Crore

  • Current Baseline: Operating at net loss; estimated baseline GMV from owned fleet: ₹40-60 Lakh/month
  • Target GMV by Quarter:
    • Q1: ₹1-1.2 Crore (monthly avg ₹33-40 Lakh)
    • Q2: ₹2-2.5 Crore (monthly avg ₹67-85 Lakh)
    • Q3: ₹5-7 Crore (monthly avg ₹1.7-2.3 Crore)
    • Q4: ₹15-20 Crore (monthly avg ₹2.5-3.3 Crore)
  • Success Metric: Compound monthly growth rate (CMGR): 25-30%
  • Drivers of GMV Growth:
    • Volume growth: Increase bookings from 500/month (Q1) → 8000/month (Q4) = 16X
    • Average order value: Increase from ₹300 (local rides) → ₹500 (mix with tours/corporate)
    • Frequency: Increase repeat bookings from 25% → 60% of users
  • Quarterly Milestones:
    • Q1: 500-800 bookings/month
    • Q2: 1500-2000 bookings/month
    • Q3: 4000-5000 bookings/month
    • Q4: 7000-8000 bookings/month

Key Result 2.2: Achieve 15-18% Commission Margin on GMV (Path to Profitability)

  • Target Commission Rate: 15% in Q1 → 18-20% by Q4 (as platform matures and partners commoditize)
  • Gross Revenue Target:
    • Q1: ₹15-20 Lakh (15% of ₹1-1.2 Cr GMV)
    • Q2: ₹30-45 Lakh (15-18% of ₹2-2.5 Cr GMV)
    • Q3: ₹85-130 Lakh (17-20% of ₹5-7 Cr GMV)
    • Q4: ₹2.7-3.9 Crore annually (18-20% of ₹15-20 Cr GMV)
  • Net Revenue After Costs (30% operating costs for tech, support, marketing):
    • Q1 Net: ₹10-14 Lakh
    • Q2 Net: ₹21-31 Lakh
    • Q3 Net: ₹60-91 Lakh
    • Q4 Net: ₹1.9-2.7 Crore annualized (run rate)
  • Success Metric: Monthly commission revenue: ₹19-30 Lakh by Dec; EBITDA positive by Q4
  • Cost Control Levers:
    • Technology: ₹1.5-2 Lakh/month (platform maintenance, hosting, SaaS tools)
    • Support: ₹1.5-2 Lakh/month (customer support team)
    • Marketing: ₹2-3 Lakh/month (gradually increasing with scale)
    • Ops: ₹1-1.5 Lakh/month (admin, payments processing)
  • Quarterly Milestones:
    • Q1: Margin stabilization; establish cost controls
    • Q2: 18% margin achieved; negative EBITDA reduced by 50%
    • Q3: 20% margin achieved; EBITDA breakeven or slightly positive
    • Q4: EBITDA positive; path to profitability clear

Key Result 2.3: Launch 3 Sister Verticals; Each Contributing 15-25% of Revenue by Q4

  • Vertical 1: Premium Tour Packages (Launch: Q1-Q2)

    • Model: Curated day/multi-day tours (Varanasi, Ayodhya, Chitrakoot, Agra, etc.)
    • Revenue Model: Markup on tour pricing (20-30%) OR commission on vehicle bookings + accommodation
    • Target: 50+ package offerings by Q2; ₹5-8 Lakh/month by Q4
    • Implementation:
      • Partner with 5-10 local tour guides
      • Integrate with OTAs (Booking.com, Airbnb Experiences)
      • Build package builder tool in platform
    • Why: Tempo Travellers are ideal for group tours; high AOV (₹2000-10000/booking)
  • Vertical 2: Corporate Travel Management (Launch: Q2)

    • Model: B2B contracts with corporations for employee transportation
    • Revenue Model: Monthly contracts (₹2-10 Lakh/month per corporate) + usage fees
    • Target: 10-15 corporate clients by Q4; ₹8-12 Lakh/month recurring revenue
    • Implementation:
      • Build corporate dashboard with billing, expense reporting, SLA tracking
      • Offer white-label branding for corporates
      • Dynamic invoicing and payment options
    • Why: High-margin, sticky revenue; predictable volume
  • Vertical 3: B2B Bulk Bookings / Sub-Agent Network (Launch: Q2-Q3)

    • Model: White-label platform for travel agents, hotel concierges, event organizers
    • Revenue Model: Commission (8-12%) on their bookings through your platform
    • Target: 50-100 B2B agents by Q4; ₹5-8 Lakh/month revenue
    • Implementation:
      • Sub-agent portal with inventory management, pricing control, commission tracking
      • API for direct integrations
      • Training and support for agents
    • Why: 2-sided marketplace expands addressable market dramatically
  • Success Metric:

    • Total revenue from verticals: 25-30% of total platform revenue by Q4
    • Individual vertical contribution:
      • Tours: ₹5-8 Lakh/month
      • Corporate: ₹8-12 Lakh/month
      • B2B: ₹5-8 Lakh/month
    • Combined: ₹18-28 Lakh/month (vs ₹25-35 Lakh from core ride-hailing)
  • Quarterly Milestones:

    • Q1: Tours vertical fully operational
    • Q2: Corporate and B2B verticals launched
    • Q3: All three verticals generating revenue, scaling operations
    • Q4: Verticals contributing 25%+ of total revenue

OBJECTIVE 3: Build Maximum Digital Presence & Tech-Driven Operations

Strategic Rationale:
Achieving 20X growth without 20X headcount is only possible through automation, digital-first operations, and intelligent use of technology. This objective ensures the business scales efficiently without becoming operational.

Key Result 3.1: Build Integrated, Scalable Tech Stack with API-First Architecture

  • Target: Fully integrated, modular platform with third-party integrations enabled
  • Core Systems:
    1. Booking Engine: Real-time availability, dynamic pricing, instant confirmation
    2. Payment Processing: Multi-gateway, wallet support, post-ride payments
    3. GPS & Tracking: Real-time driver location, ETA, route optimization
    4. CRM System: Customer profiles, booking history, personalization
    5. Business Intelligence: Analytics dashboard, KPI tracking, predictive modeling
    6. Notification Engine: Push, SMS, email, WhatsApp notifications
    7. Support Platform: Chat, ticket management, knowledge base
    8. Partner Portal: Vehicle management, earnings, performance tracking
  • Success Metrics:
    • 99.5% uptime
    • <500ms response time (p95)
    • Support ticket resolution: <4 hours for urgent issues
    • API uptime: 99.9% for third-party integrations
  • Technology Recommendations (Budget: ₹20-30 Lakh for Year 1):
    • Backend: Node.js + PostgreSQL (proven for ride-hailing at scale)
    • Frontend: React Native (mobile), React (web)
    • Real-time: Socket.io or Firebase for live tracking
    • Analytics: Segment + Mixpanel for event tracking
    • Infrastructure: AWS (auto-scaling, multi-region for future expansion)
    • Payments: Razorpay (best for India with UPI support)
    • Messaging: Twilio (SMS/WhatsApp)
  • Quarterly Milestones:
    • Q1: MVP with core booking, payment, tracking
    • Q2: Partner portal, advanced analytics, dynamic pricing engine
    • Q3: Third-party integrations (hotels, events, OTAs)
    • Q4: AI-powered recommendations, predictive demand, personalization

Key Result 3.2: Achieve 80%+ Digital Booking Penetration (Eliminate Phone-Based Booking Dependency)

  • Current State: Assumed ~20-30% digital bookings (phone/offline still dominant)
  • Target: 80%+ bookings through app/web by Q4
  • Why It Matters:
    • Phone bookings require support staff (₹1-2 Lakh/month)
    • Digital bookings are scalable, customer data captured, lower CAC
    • Enables analytics, personalization, automated workflows
  • Tactics:
    • Q1: Launch app with sign-up incentive (₹100 credit for first booking)
    • Q2: Gamification - loyalty points for app bookings
    • Q3: WhatsApp bot integration (easy booking via WhatsApp)
    • Q4: One-click booking, saved preferences, scheduled rides
  • Success Metric:
    • Q1: 45% digital bookings
    • Q2: 60% digital bookings
    • Q3: 75% digital bookings
    • Q4: 85%+ digital bookings
  • KPIs to Track:
    • App downloads: 10,000+ by Q4
    • Daily active users: 500+
    • Monthly active users: 3000+
    • App retention (7-day): 50%+
    • App rating: 4.5+

Key Result 3.3: Deploy AI-Driven Operations for 30% Efficiency Improvement

  • Components:

    1. Dynamic Pricing Engine:

      • Algorithm: Demand surge detection + supply availability + time of day
      • Benefit: 15-20% higher revenue at peak times; maintain affordability off-peak
      • Implementation: Start simple (time-based), progress to ML-based
    2. Demand Forecasting:

      • Predict peak hours, locations, trip types 24-48 hours ahead
      • Enables: Driver pre-positioning, partner scheduling, inventory optimization
      • Benefit: 20-25% improvement in vehicle utilization
    3. Automated Dispatch & Matching:

      • ML-based driver-customer matching (not just nearest, but based on rating, acceptance rate, route)
      • Goal: Reduce empty miles, improve acceptance rates
      • Benefit: 15% reduction in driver rejection, faster pickup times
    4. Predictive Analytics:

      • Identify high-churn partners/drivers before they leave
      • Predict customer LTV and tailor retention efforts
      • Benefit: Improve partner retention from 80% to 95%+
    5. Intelligent Support (Chatbot):

      • Resolve 60%+ of support tickets via AI chatbot (booking issues, FAQs, refunds)
      • Reduce support team workload by 40%
      • Benefit: Cost savings + faster resolution times
  • Success Metric:

    • Fleet utilization: 75%+ (from current ~50%)
    • Cost per booking: 30% reduction
    • Partner retention: 90%+
    • Support ticket resolution time: 50% reduction
    • Driver acceptance rate: 85%+ (from ~70%)
  • Implementation Roadmap:

    • Q1: Deploy basic demand forecasting (historical data analysis)
    • Q2: Dynamic pricing engine live
    • Q3: AI-based matching, chatbot support
    • Q4: Full predictive analytics suite

Key Result 3.4: Implement Comprehensive Data Analytics & Business Intelligence

  • Target: Real-time dashboards tracking all key metrics by Q2
  • Dashboard Components:
    • Operations Dashboard: Real-time ride metrics, fleet utilization, partner performance
    • Business Dashboard: Revenue, commission, profitability, KPIs
    • Customer Dashboard: Acquisition, retention, LTV, NPS
    • Product Dashboard: Feature usage, conversion funnels, booking flow optimization
  • Key Metrics to Track:
    • GMV, bookings, commission revenue (updated hourly)
    • Daily active users, repeat booking rate
    • Partner on-time performance, rating distribution
    • CAC, LTV, churn rate, NPS
  • Investment: ₹1-1.5 Lakh/month for analytics tools + 1 data analyst
  • Success Metric: 95%+ uptime of dashboards; decision-making driven by data

OBJECTIVE 4: Establish Market Leadership & Geographic Expansion

Strategic Rationale:
The Kashi market is the starting point. Dominating locally (80%+ market share) provides a proof-of-concept, generates case studies, and funds expansion. Adjacent Tier-2 cities (Lucknow, Agra, Allahabad) have similar demand patterns and lower competition than metros.

Key Result 4.1: Achieve 80%+ Market Share in Organized Taxi Segment in Kashi

  • Current Market: Kashi has ~1.5-2 million residents; estimated 500+ organized taxis (Ola, Uber penetration: ~20-30%)
  • Target: Capture 60-70% of daily bookings from organized segment (80% share implies ~300+ daily bookings)
  • Strategy:
    • Hyper-local dominance: 24/7 availability, <5 min avg wait time
    • Local pricing: 5-10% cheaper than Ola/Uber during off-peak
    • Community events: Sponsor local events, high school programs, corporate partnerships
    • Driver incentives: Guaranteed earnings for top drivers (₹15-20/hour minimum guarantee)
  • Success Metric:
    • Daily bookings: 300+ by Q4
    • Market awareness: 80%+ unaided brand recall in Kashi
    • App downloads: 10,000+ from Kashi region
    • Net Promoter Score (NPS): 60+
  • Quarterly Milestones:
    • Q1: 30% market share (estimated 100-120 daily bookings)
    • Q2: 50% market share (estimated 150-180 daily bookings)
    • Q3: 65% market share (estimated 200-240 daily bookings)
    • Q4: 80%+ market share (estimated 300+ daily bookings)

Key Result 4.2: Acquire 15,000+ Active Customers with Healthy Unit Economics (LTV:CAC = 3:1+)

  • Customer Acquisition Strategy:

    • Tier 1 (50%): Referral-based (lowest CAC, highest quality)
    • Tier 2 (30%): Organic (app store optimization, word-of-mouth)
    • Tier 3 (20%): Paid digital marketing (Instagram, Google Ads, local influencers)
  • CAC & LTV Targets:

    • Target CAC: ₹150-250 per customer
    • Target LTV: ₹500-900 (12-month basis)
      • Avg bookings per user: 4-6/month
      • Avg order value: ₹300-350
      • Repeat rate: 60%+ by Q4
      • Gross margin: 15-20%
      • Lifetime: 12 months before churn
    • LTV:CAC Ratio: 3:1 to 5:1 (healthy benchmark: 3:1+)
  • Acquisition Tactics:

    • Q1: Organic + seeding (free/discounted rides to 500+ early adopters)
    • Q2: Referral program launch (₹50 credit for referrer + referee)
    • Q3: Influencer partnerships (10-15 local influencers)
    • Q4: Seasonal campaigns (Holi, Diwali, New Year)
  • Retention Tactics:

    • Loyalty program: Points per ride, redeemable for discounts
    • Personalization: Recommended rides based on history
    • Surprise & delight: Random discounts for loyal customers
    • Win-back: Re-engagement offers for inactive users
  • Success Metric:

    • Q1: 2,000 active customers
    • Q2: 5,000 active customers
    • Q3: 10,000 active customers
    • Q4: 15,000+ active customers
    • Repeat booking rate: 60%+ by Q4
    • Monthly churn: <5%

Key Result 4.3: Expand to 2-3 Adjacent Markets (Lucknow, Agra, Allahabad Region)

  • Market Selection Criteria:

    • Population: 500K+ (similar to Kashi)
    • Tourism: High footfall (Agra=Taj Mahal, Lucknow=heritage, Allahabad=pilgrim hub)
    • Competition: Low (less Ola/Uber penetration than metros)
    • Economic feasibility: Quick breakeven possible
  • Expansion Timeline:

    • Lucknow Pilot: Launch end of Q2 (late June)
    • Agra Launch: Launch early Q3 (July)
    • Allahabad/Third City: Launch mid Q3 (August)
  • Playbook for Expansion (Replicate from Kashi):

    • Week 1-2: Market research, competitor analysis, partner identification
    • Week 3-4: Recruit 5-10 local vehicle partners, train team
    • Week 5-6: Soft launch (500-1000 promo rides)
    • Week 7-8: Full launch with marketing blitz
  • Success Metric per Market:

    • Month 1: 50-100 bookings
    • Month 2: 200-300 bookings
    • Month 3: 400-500 bookings (steady state)
    • Breakeven: Month 3-4
  • By Q4:

    • Lucknow: 400-500 daily bookings
    • Agra: 300-400 daily bookings
    • Allahabad/Third: 200-300 daily bookings
    • Total across 4 cities: 1000+ daily bookings
  • Investment Required: ₹5-8 Lakh per new city (team, ops, marketing)

Key Result 4.4: Build Brand Authority & Customer Trust (NPS 60+, 4.6+ App Rating)

  • Components:

    • Customer satisfaction: Average rating >4.6 (on Playstore and in-app)
    • Support responsiveness: <2 hours reply time, 95%+ resolution in first contact
    • Safety: 5-star safety record, verified drivers, SOS integration
    • Transparency: Clear pricing, no surge pricing deception, real-time tracking
  • Tactics:

    • Collect feedback after every ride (SMS/push survey)
    • Act on feedback publicly (show what you fixed)
    • Highlight positive reviews in marketing
    • Engage with negative reviews (resolve on-ground, show commitment)
  • Success Metric:

    • Playstore rating: 4.5+ (10,000+ reviews)
    • NPS: 60+ (from quarterly surveys)
    • Customer satisfaction: 85%+ positive sentiment
    • Support CSAT: 90%+

QUARTERLY BREAKDOWN & DETAILED MILESTONES

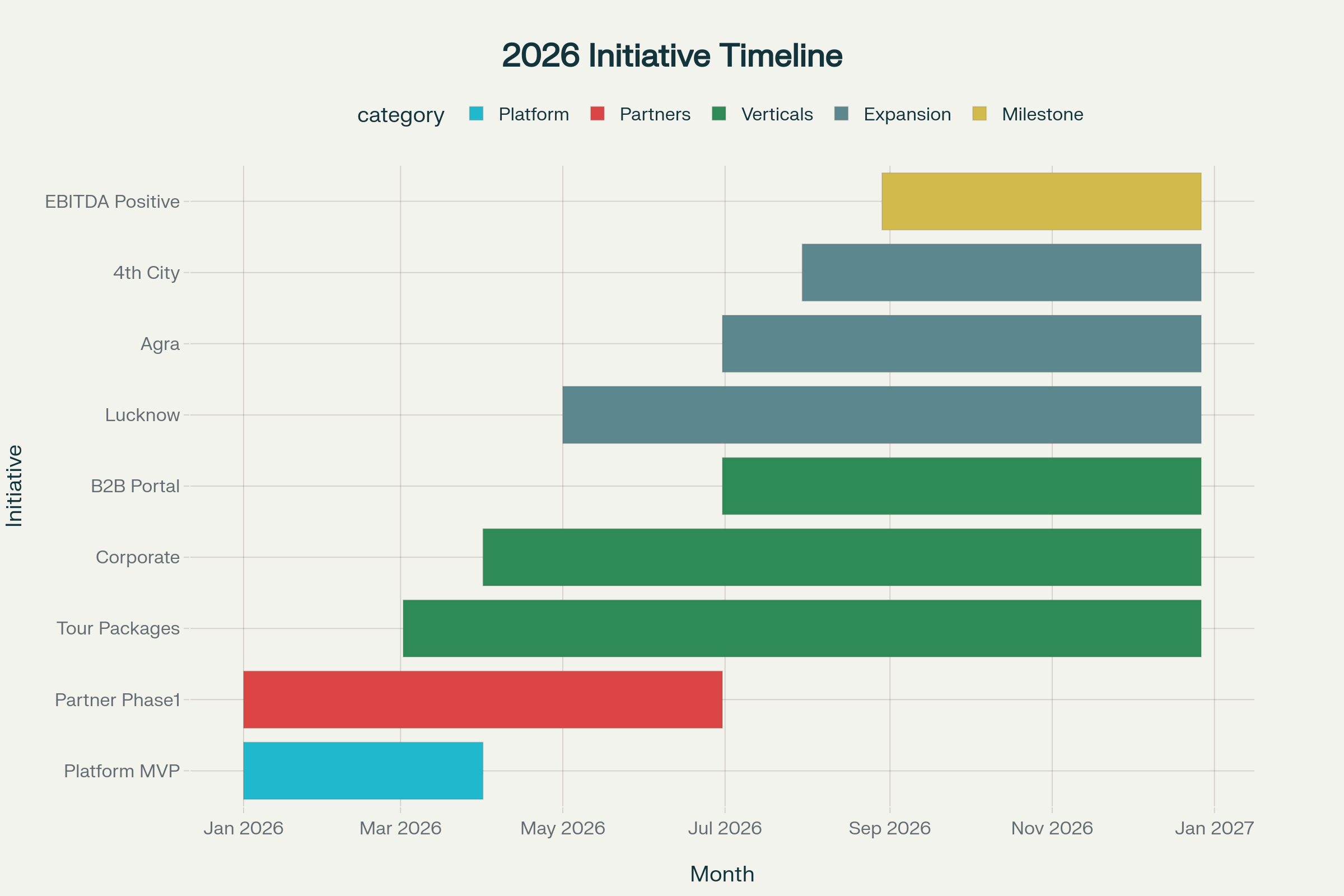

Quarterly Implementation Timeline Figure 3: Quarterly milestones and implementation timeline for 2026

Q1 2026: FOUNDATION PHASE (Jan-Mar)

Theme: Launch Platform + Pilot Partner Network + Establish Profitability Path

Q1 OKR 1: Platform Launch & Initial Partner Onboarding

  • Platform MVP live by March 31
    • Booking app (iOS + Android) with GPS tracking, in-app payments
    • Partner dashboard (vehicle management, earnings, ratings)
    • Admin dashboard (analytics, commission tracking, support)
  • 15-20 vehicle partners onboarded and active
    • Mix: 8-10 sedan owners + 5-8 SUV/tempo traveller operators
    • 90%+ documentation completion rate
    • <10 hours time-to-live for partners
  • Customer base: 2,000+ registered users
    • 500-800 bookings by end of March
    • 35%+ repeat booking rate
    • 4.5+ app rating

Q1 OKR 2: Revenue Stabilization & Cost Control

  • Platform GMV: ₹80-100 Lakh (monthly average ₹27-33 Lakh)
  • Commission revenue: ₹12-15 Lakh (15% margin)
  • Owned vehicle utilization: Reduced from 100% to 60%
    • Start process to sell 3-4 vehicles
    • Finalize paperwork for 5+ vehicles by end of Q1
  • Operating cost: <₹6 Lakh/month (tech, support, basic marketing)
    • CAC: <₹200 per user (mostly organic + seeding)
    • Burn rate: Reduced to ₹2-3 Lakh/month (from baseline loss)

Q1 OKR 3: Technology Roadmap & Infrastructure

  • Tech stack selected and 70% implemented
    • Backend, database, payment gateway: Integrated
    • Mobile apps: iOS + Android in closed beta, ready for public release
  • Real-time tracking system: Operational
  • Payment processing: Zero payment failures (target: 99.9% success rate)
  • Analytics infrastructure: Google Analytics + custom dashboard
  • Support ticketing: Zendesk or similar setup

Q1 OKR 4: Market Research & Expansion Planning

  • Lucknow market research: Complete (competitors, demand, partner landscape)
  • Agra feasibility study: Complete
  • Local partnerships identified (hotels, event organizers, corporate offices)
  • Expansion budget: ₹5-8 Lakh allocated and approved

Q1 Key Initiatives:

  • Incorporate company as technology platform business (if separate legal entity)
  • Website & landing page: Rebuild to highlight commission model for partners
  • Press release: "Kashi Taxi Launches Digital Platform" (local media coverage)
  • Partner kick-off event: Host 20-30 partners, training, incentive structure reveal
  • Brand guidelines: Finalize colors, logo, messaging for scaling
  • Legal: Finalize partner agreements, SLA templates, terms of service

Q2 2026: SCALING PHASE (Apr-Jun)

Theme: 2X Bookings Growth + Corporate/Tour Verticals + Lucknow Pilot

Q2 OKR 1: Rapid Booking Growth & Platform Enhancement

  • Bookings: 1,500-2,000/month (2-2.5X from Q1)
    • Driven by: App marketing (₹2-3 Lakh/month spend), referral program, seasonal demand
  • Partner network: 25-35 active partners
    • 50%+ of bookings from partners
    • New partner onboarding: 2-3/week
  • Platform features added:
    • Dynamic pricing engine: Live by May
    • Ride scheduling: 1-7 days in advance
    • Driver ratings and profiles visible before booking
    • In-app chat between driver and customer

Q2 OKR 2: Revenue Diversification & Margin Improvement

  • Platform GMV: ₹2-2.5 Crore (monthly avg ₹67-85 Lakh)
  • Commission revenue: ₹30-45 Lakh (18-20% margin, improved from Q1)
  • Tour packages vertical: Launch by May 15
    • 50+ package offerings (Varanasi, Agra, Ayodhya, Chitrakoot)
    • ₹3-5 Lakh revenue in June
    • Partnership with 3-5 local tour guides
  • Corporate vertical: Soft launch by end June
    • Target: 2-3 pilot corporate clients
    • Dashboard: Ready for corporate expense tracking
    • Estimated revenue: ₹1-2 Lakh in June (ramping up)

Q2 OKR 3: Brand & Customer Acquisition

  • Active users: 5,000+
  • Playstore rating: 4.4+ (from 10k+ downloads)
  • Referral program: 20%+ of new bookings from referrals
  • Marketing channels:
    • Q2 spend: ₹5-6 Lakh on digital marketing
    • Focus: Instagram, local influencers, Google Ads in Kashi
  • CAC: ₹150-200 (down from Q1 as referral increases)
  • NPS: 55+

Q2 OKR 4: Geographic Expansion - Lucknow Pilot

  • Lucknow launch: June 15 (soft launch June 1)
  • First 100 bookings: Achieved by June 20
  • Partner network: 8-10 vehicle partners onboarded
  • Lucknow revenue: ₹2-3 Lakh (June only)

Q2 Key Initiatives:

  • Referral program go-live (₹50 each for referrer + referee)
  • Tour packages: Website built, packages live on platform
  • Corporate dashboard: Feature complete and user-tested
  • Marketing blitz: Hoardings, local radio, event sponsorships in Kashi
  • Staff expansion: Hire partner manager + customer support (2-3 people)
  • Series A fundraising (if needed): Prepare pitch deck for ₹50-100 Cr valuation potential

Q3 2026: EXPANSION PHASE (Jul-Sep)

Theme: 2-3X Booking Growth + Multi-City Operations + New Verticals Ramping

Q3 OKR 1: Scale to 4 Cities + 5K Daily Bookings

  • Total daily bookings: 4,000-5,000 (vs 1,500-2,000 in Q2)
    • Kashi: 300-350/day
    • Lucknow: 1,200-1,500/day (ramping from pilot)
    • Agra: 1,000-1,500/day (launch early July)
    • New City (Allahabad/Varanasi expansion): 500-800/day (launch by mid-Aug)
  • Partner network: 50+ total across cities
  • Platform GMV: ₹5-7 Crore

Q3 OKR 2: Revenue Acceleration & Verticals Scaling

  • Commission revenue: ₹85-130 Lakh
  • Tour packages: ₹5-8 Lakh/month (from full-month operations)
  • Corporate contracts: ₹8-12 Lakh/month (3-5 corporate clients with contracts)
  • B2B bulk booking: Launched by Aug; ₹2-3 Lakh in Sept
  • Total monthly revenue: ₹1-1.4 Crore (run rate)

Q3 OKR 3: Technology & Operations at Scale

  • Platform: 99.5% uptime maintained
  • AI/ML features: Predictive demand live, dynamic pricing improving margins
  • Chatbot support: Handling 50%+ of support tickets
  • Fleet utilization: 75%+ (vs 60% in Q1)
  • Partner retention: 90%+ (monthly)

Q3 OKR 4: Team & Infrastructure Build-Out

  • Headcount: 15-20 people (from 5 in Q1)
    • Platform/tech: 5-6 engineers
    • Operations/partners: 2-3 managers
    • Customer support: 4-5 people
    • Business development: 2-3 people
    • Admin/finance: 1-2 people
  • Office space: Move to 1500-2000 sqft space (all cities)
  • Tech infrastructure: Multi-region AWS setup for reliability

Q3 Key Initiatives:

  • Agra launch: Mid-July
  • Allahabad/fourth city launch: Mid-August
  • B2B portal: Live for agents to book rides
  • Corporate dashboard: 5+ signed contracts
  • API marketplace: Third-party integrations live (hotels, events, OTAs)
  • Fundraising close: Complete Series A or Series B (if needed)

Q4 2026: CONSOLIDATION & PROFITABILITY PHASE (Oct-Dec)

Theme: Achieve 20X Target + Path to Profitability + Year 2 Expansion Blueprint

Q4 OKR 1: 20X Revenue Target Achievement

  • Platform GMV: ₹15-20 Crore (annual)
  • Annual commission revenue: ₹2.25-3.6 Crore (20X from baseline)
    • Monthly revenue run rate: ₹2.5-3.3 Crore by December
  • Owned vehicles: Liquidated down to 2-3 (from initial 10)
    • Capital freed up: ₹30-40 Lakh
  • EBITDA positive: ₹50-75 Lakh in Q4 month-on-month

Q4 OKR 2: Consolidated Multi-City Operations

  • Cities operational: 4-5 (Kashi, Lucknow, Agra, + 1-2 others)
  • Total daily bookings: 7,000-8,000
  • Partner network: 75-100+ across all cities
  • Employee headcount: 20-25 people
  • Monthly revenue: ₹2.5-3.3 Crore

Q4 OKR 3: Enterprise Readiness & Strategic Partnerships

  • API ecosystem: 10+ live integrations
    • OTA partnerships (Booking.com, Agoda for transfer services)
    • Event management platforms
    • Hotel concierge integrations
    • Corporate travel tools
  • Mobile app: 50,000+ downloads, 4.6+ rating
  • Customer base: 15,000+ registered, 5,000+ monthly active
  • NPS: 65+

Q4 OKR 4: Year 2 Expansion Roadmap & Fundraising

  • Roadmap: 10-15 cities by end of Year 2
  • Target valuation: ₹500 Cr - ₹1000 Cr (Series B/C)
  • Expansion capital: Raised ₹50-100 Cr (Series A/B)
  • International interest: Explore Indonesia, Bangladesh, Philippines

Q4 Key Initiatives:

  • Year-end celebration: Town hall with all partners and staff
  • Press coverage: "From loss to ₹200 Cr+ revenue run rate" (media narrative)
  • Series B/C fundraising: Complete, prepare for Year 2 expansion
  • Five-city profitability analysis: Prove unit economics for replication
  • Product roadmap 2027: Publish vision (AI, insurance, credit, etc.)
  • Strategic partnerships: Sign LOIs with 2-3 major OTA/corporate customers

RE-REVISED OKRs (VERSION 2.0 - OPTIMIZED & OPERATIONAL)

Based on critical thinking and iteration, here are the refined OKRs with higher clarity and operational focus:

REVISED OBJECTIVE 1: Transition to Asset-Light Model with 75+ Operational Partners

Strategic Change: Focus moved from "building platform" to "operational partners executing bookings." Platform is enabler; partners are value creators.

Revised KR 1.1: Transition 75% of revenue from owned vehicles to partner-operated vehicles by Q4

  • Better metric than "70% of fleet" because it's outcome-focused
  • Target: ₹1.5-2 Crore of ₹2.25-3.6 Crore revenue from partners
  • Ensures capital efficiency and unit economics

Revised KR 1.2: Achieve 95%+ operational uptime and <5min avg pickup time

  • More specific and measurable than "launch platform"
  • Directly impacts customer satisfaction and retention
  • Success metric: <5 min avg pickup, 4.6+ app rating

Revised KR 1.3: Onboard, train, and sustain 75-100 active vehicle partners at 90%+ retention

  • Clearer than just "50+ partners"
  • Monthly retention target of 90%+ built in
  • Includes training and support infrastructure

REVISED OBJECTIVE 2: Generate ₹2.25-3.6 Crore Revenue with 20%+ Profit Margins

Strategic Change: Shifted from "diversity of verticals" to "disciplined profitability." Verticals are secondary to core ride-hailing economics.

Revised KR 2.1: Build platform GMV to ₹18-22 Crore with 18-20% commission margin

  • More precise target range based on industry benchmarks
  • Quarterly targets: Q1: ₹1 Cr | Q2: ₹2.5 Cr | Q3: ₹6 Cr | Q4: ₹18+ Cr
  • Success metric: ₹2.5-3.6 Crore annual gross revenue

Revised KR 2.2: Maintain <30% cost-to-revenue ratio; achieve EBITDA positive by Q3

  • More specific than "margin improvement"
  • Built-in path to profitability
  • Q3 becomes breakeven; Q4 generates cash

Revised KR 2.3: Diversify revenue (non-ride bookings) to 20-25% of total

  • Tours, corporate, B2B: Combined ₹50-90 Lakh/month by Q4
  • Reduces single-revenue-stream risk
  • High-margin opportunities

REVISED OBJECTIVE 3: Scale Platform to 15,000+ Customers Across 4 Cities

Strategic Change: Shifted focus to customer acquisition and retention with clear unit economics.

Revised KR 3.1: Acquire 15,000+ customers with LTV:CAC ratio of 3.5:1+

  • More precise than "acquire customers"
  • Built-in unit economics benchmark
  • Ensures sustainable growth
  • CAC target: ₹150-200 | LTV target: ₹600-900

Revised KR 3.2: Expand profitably to 4 cities by Q4 with <3 month payback per city

  • Ensures disciplined expansion (not "expand for expansion's sake")
  • Each city must hit ₹1-2 Cr GMV by month 4
  • Proves repeatable model

Revised KR 3.3: Build brand with 4.7+ app rating, 65+ NPS, 80%+ unaided brand recall in primary markets

  • Clear brand metrics
  • Indicates product-market fit
  • Drives organic growth

REVISED OBJECTIVE 4: Build Defensible Technology Moat

Strategic Change: New objective focused on durable competitive advantage; not just scale.

Revised KR 4.1: Deploy AI/ML capabilities (dynamic pricing, demand forecasting, matching) improving unit economics by 25%+

  • Fleet utilization: 75%+
  • Cost per booking: Down 25%
  • Partner earnings: Up 10-15% (improves retention)

Revised KR 4.2: Achieve 85%+ digital booking penetration with app as primary interface

  • Scalability without ops headcount
  • Lower CAC than phone-based
  • Enables data collection for personalization

Revised KR 4.3: Build API-first platform enabling 10+ third-party integrations

  • Hotels, OTAs, event organizers, corporate systems
  • Creates ecosystem effect
  • Network effects improve defensibility

IMPLEMENTATION ROADMAP & SUCCESS FACTORS

Critical Success Factors

  1. Partner Economics Must Work (or model fails)

    • Vehicle owner: Gets consistent ₹10-15K/month from platform
    • Driver: Makes ₹15-20K/month (vs ₹8-10K in traditional models)
    • Kashi Taxi: Captures ₹3-5K commission per partner/vehicle/month
    • If any party unhappy → high churn
  2. Technology Must Be Reliable

    • 99.5%+ uptime is non-negotiable
    • Failed bookings = lost customers forever
    • Budget adequately for infrastructure
  3. Customer Experience Must Be Superior

    • <5 min pickup time (vs 8-12 for competitors)
    • 4.5+ app rating (retention driver)
    • Supportive customer service (under-promise, over-deliver)
  4. Unit Economics Must Be Clear

    • Know CAC, LTV, churn, repeat rate for each cohort
    • Optimize constantly
    • Make data-driven decisions
  5. Execution Speed

    • Platform MVP: 12 weeks (not 6 months)
    • New city: 8 weeks (not 16 weeks)
    • Feature launches: 2-week sprints
  6. Team Quality

    • Hire senior people early (engineer, operations, finance)
    • Avoid "solopreneur trap"
    • Build management infrastructure

Resource Requirements

Team (20-25 by end of Year 1)

  • Founder/CEO: 1
  • Tech lead/VP Eng: 1
  • Engineers: 4-5
  • Product manager: 1
  • Partner manager: 2-3
  • Customer support: 3-4
  • Marketing/growth: 2-3
  • Finance/ops: 1-2

Budget (₹30-50 Lakh for Year 1)

  • Platform development: ₹12-15 Lakh
  • Infrastructure/hosting: ₹1.5-2 Lakh
  • Marketing/user acquisition: ₹8-10 Lakh
  • Team salaries: ₹6-8 Lakh
  • Operational costs: ₹2-3 Lakh

Key Risks & Mitigation

Risk Impact Mitigation
Partner churn (low earnings) 40-50% of bookings lost Guarantee min ₹12K/month per partner; build community
Competitor price war (Ola/Uber focus) Revenue compression Differentiate on service + local presence; focus on tier-2 markets
Tech failures/downtime Customer loss, reputation damage 99.5% uptime SLA; redundant systems; on-call engineers
Customer acquisition cost inflation Unit economics break Focus on referral (low CAC); organic growth; B2B (corporate) channels
Regulatory changes License suspension, fines Comply strictly; maintain relationships with transport authority
Staff burnout at scale Quality degradation Build sustainable processes; hire ahead of growth; document everything

TRACKING & ACCOUNTABILITY

Critical Red Flags & Response Actions

Early warning system to prevent strategic drift and operational failures:

Red Flag / Trigger Response Action
Booking growth <30% QoQ Review marketing effectiveness; increase spend or change channels
Partner monthly churn >15% Investigate partner earnings; conduct partner satisfaction survey
CAC >₹250 Evaluate acquisition channels; increase referral/organic focus
App rating falls below 4.3 Escalate support issues; implement product improvements
Platform uptime <99% Emergency infrastructure audit; hire DevOps support
Partner retention <85% Raise partner commissions by 1-2%; improve support SLA
NPS drops below 40 Conduct customer research; fix product issues
Repeat booking rate <40% Enhance loyalty program; personalize recommendations
Commission margin <12% Reduce operating costs; audit discretionary spending
Cost per booking >₹100 Optimize dispatch algorithm; reduce empty rides

Revenue Waterfall Progression

Revenue Stream Amount (₹ Lakh) Cumulative (₹ Lakh)
Q1 Base (Platform) 15 15
Q2 Growth (Volume) 25 40
Q2 Tours Vertical 5 45
Q3 Growth (Volume) 70 115
Q3 Corporate Contracts 10 125
Q4 Growth (Volume) 190 315
Q4 B2B Revenue 10 325
Q4 All Verticals 50 375

Monthly Check-in (Every 1st of month)

  • Review key metrics: GMV, bookings, revenue, CAC, LTV, churn
  • Traffic light status on all OKRs (Green/Yellow/Red)
  • Identify blockers and course corrections

Quarterly Review (Every end of quarter)

  • Full OKR assessment (0.0 to 1.0 scoring)
  • Board presentation (if investors)
  • Plan next quarter's initiatives
  • Team celebration of wins

Annual Review (Every December)

  • Year-end OKR retrospective
  • 20X target vs actual analysis
  • Learnings for Year 2
  • Year 2 OKR planning

CONCLUSION

This OKR framework provides a clear, ambitious yet achievable roadmap to 20X revenue growth in 12 months. The transition from asset-heavy to asset-light model is not just a strategy shift—it's essential for profitability and scalability.

The 20X target breaks down as:

  • 5-7X growth from increased platform volume (500 → 8000 monthly bookings)
  • 2-3X improvement from margin optimization and cost reduction
  • 2-3X from vertical diversification (tours, corporate, B2B)

Success requires:

  1. Flawless execution on platform launch (Q1)
  2. Aggressive but disciplined scaling (Q2-Q3)
  3. Profitability focus and capital efficiency (Q4)
  4. Continuous measurement and optimization

With focus, discipline, and consistent execution, Kashi Taxi can become a ₹200+ Crore revenue run-rate business by end of Year 1, creating a template for expansion across India's Tier-2 cities.

Document Version: 2.0 (Revised & Re-Revised)
Last Updated: Q4 2025
Next Review: January 2026 (Q1 Planning)

🚕 Quick Booking

Get instant quote

Prefer talking? Call 94503 01573

Need help planning your trip?

Get personalized assistance for your Varanasi journey
